Introduction
On September 10, 2026, the Federal Energy Regulatory Commission (FERC or the Commission) issued an order authorizing Gulf South Pipeline Company, LLC and Texas Gas Transmission, LLC to construct and operate the Kosciusko Junction Pipeline Project (Docket Nos. CP25-547-000 and CP25-549-000), subject to environmental conditions.
The Commission’s decision follows FERC staff’s environmental review of the Project, including the final Environmental Impact Statement (EIS) issued on July 24, 2026.
More information may be found in Docket Nos. CP25-547-000 and CP25-549-000 in FERC’s eLibrary.
Kosciusko Junction Pipeline Project Route and Description
As described by the Applicants, the planned Project is a pipeline and compressor station construction project.
The Project entails constructing:
- Approximately 102 miles of new 36-inch pipe from Attala to Clarke Counties, MS
- Approximately 8 miles of new 36-inch pipe in Humphreys & Sunflower Counties, MS
- One new Kosci Compressor Station in Attala County, MS
- One new Holmes Compressor Station in Holmes County, MS
- Modifications to the company’s existing Greenville Compressor Station in Washington County, MS and Isola Compressor Station in Humphreys County, MS

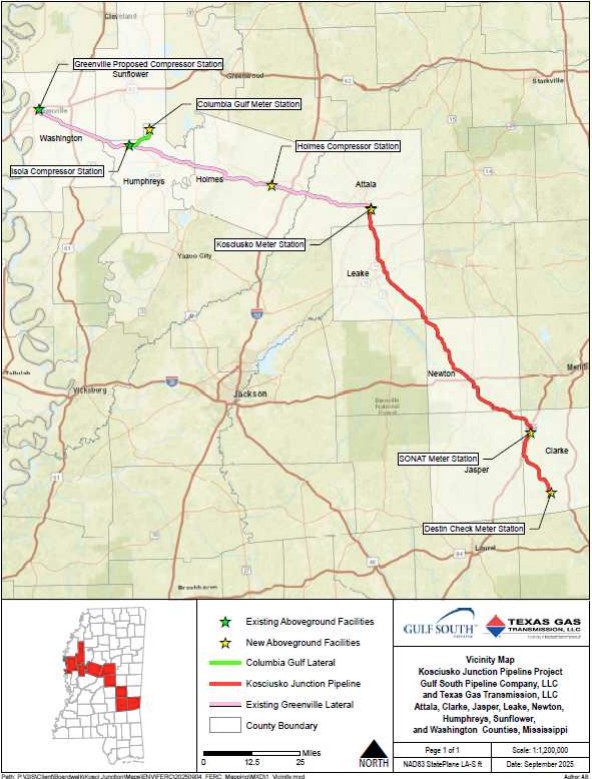

On February 7, 2025, the Applicants submitted this Project map to the docket. To view and download this map, please visit FERC's eLibrary and search Docket No. PF25-6-000.
Schedule for Environmental Review
April 1, 2026: Draft EIS issued (Complete)
July 24, 2026: Notice of Availability and Final EIS issued (Complete)
September 10, 2026: Final Order issued (Complete)
October 2026: Federal Authorization Decision Deadline (Complete; federal permitting completed September 23, 2026)
Public Participation Opportunities
Comment Periods
The public comment periods on the application and the draft EIS have closed.
Construction and Compliance
Before construction can begin, the companies must satisfy the environmental conditions in the order. FERC staff monitor construction for compliance with those conditions.
Landowners and community members with concerns during construction may contact the FERC Landowner Helpline at 1-877-337-2237 or [email protected].
To receive email notifications of filings and issuances in the docket, including compliance filings and construction updates, you may sign up for eSubscription.
More Information and Staying Updated
You may learn more about the Project through FERC’s eLibrary. When searching for the Project, please enter Docket No. CP25-547-000 in the “Enter Docket Number” text box. FERC’s Office of Public Participation provides an educational video and demonstration on using eLibrary: WorkshOPP and Demonstration: FERC’s eLibrary.
Stay Informed:
Follow OPP on its social media channels:
OPP regularly sends announcements about upcoming participation opportunities and meetings with interested stakeholders and organizations via its social media channels.
You may also sign up for FERC’s eSubscription service. eSubscription notifies you via email about submittals and issuances on the project. Please visit www.ferc.gov/esubscription.
You are also encouraged to contact OPP staff to learn more about the Project and participation at FERC by email at [email protected] or phone at 202-502-6595. All media inquiries should be directed to [email protected].
Resources
Guides on Public Participation
- Step-by-step guide on how to file a comment
- Step-by-step guide on how to eSubscribe
- Step-by-step guide on how to intervene
Educational Videos
- Learn to eFile, eComment, and eSubscribe
- How to File an Intervention Using FERC’s Online System
- Filing Comments Workshop and Demonstration
- Submitting Powerful Comments Workshop
Tips on Public Participation
Informational Handouts
Background
- February 7, 2025: Gulf South Pipeline Company, LLC, and Texas Gas Transmission, LLC, files a request to initiate the Pre-filing Process with FERC
- February 27, 2025: FERC approves the Applicants request to begin the Pre-Filing review for the Kosciusko Junction Pipeline Project
- May 7, 2025: FERC issues a Notice of Scoping Period
- September 25, 2025: FERC publishes a Notice of Application in the project docket, establishing the deadline for filing motions to intervene
- October 16, 2025: FERC deadline for requested public comments on the scope of issues to address in the environmental document.
- October 31, 2025: Gulf South Pipeline Company, LLC and Texas Gas Transmission, LLC submitted responses to comments filed by various parties regarding the Kosciusko Junction Pipeline Project (Docket No. CP25-547). The filings are available in FERC’s eLibrary under the project docket number.
- April 1, 2026: FERC issues Draft Environmental Impact Statement for the Kosciusko Junction Pipeline Project
- April 2026: FERC held three Draft EIS public comment sessions in the potentially affected areas.
- May 26, 2026: The deadline to submit comments for the draft Environmental Impact Statement (EIS).
- July 24, 2026: The Issuance of Notice of Availability of the final EIS and the Final EIS was issued.
- September 10, 2026: FERC issues order authorizing the Kosciusko Junction Pipeline Project
Office of Public Participation's Outreach Corner
The Office of Public Participation (OPP) is authorized to support public participation in FERC proceedings pursuant to Section 319 of the Federal Power Act. OPP coordinates with and provides assistance to members of the public as to participation in, and understanding of, FERC proceedings. OPP provides outreach to community groups, community members, landowners and other interested parties potentially impacted by infrastructure projects.
OPP outreach conducted for the Kosciusko Junction Pipeline Project (Docket No. PF25-6-000) included:
- On January and March 2025, potentially affected landowners and interested stakeholders were notified via email and the U.S. Postal Service about the open house and scoping session for the Kosciusko Junction Pipeline Project. The messages provided information on how to participate in the environmental review process, including details about the open house events and opportunities to submit scoping comments.
- OPP Outreach Specialists attended the Open Houses and Scoping Sessions in the potentially affected areas in the Spring of 2025.
- Coordinated social media campaign in Spring 2025 to notify interested constituents of the environmental review process, events, and associated deadlines on social media outlets Facebook, Instagram, and X.
- Spring 2026: OPP conducted expanded outreach for the draft Environmental Impact Statement deadline, including postal mailers, emails, and community and constituent meetings.
